Stresemannallee Building Project

[Translate to english:] Bauvorhaben Stresemannallee Teaser

Stresemannallee

Since December 2014, line 17 has run from Rebstockbad in Bockenheim via the trade fair grounds, the central station, Friedensbrücke and the Stadtwald forest to Stadtgrenze Neu-Isenburg. The direct connection between Neu-Isenburg and the central station is part of the planned Frankfurter Ring tram line. The former tram line 14 has been retained and runs from Ernst-May-Platz reaching Louisa-Schleife, where a changeover to the “new” line 17 is possible.

With a total of 18 stops, the new tram line provides new connections and faster journeys: The Opera and the Schauspielhaus are now only 16 minutes from Neu-Isenburg with a changeover at Baseler Platz, while the Senckenberg Museum can be reached from Ludwig-Ehrhard-Anlage in 18 minutes. Frankfurt central station can be reached from the southern city limit on a direct, barrier-free journey in 13 minutes. At Südbahnhof, with the lines U1, U2, U3 and U8, there’s a connection to tram line 14 to Louisa.

The new line 17: Facts & Figures

  • Length of the new section: 1.1 kilometres
  • New stops: 1 (Stresemannallee)
  • Future lines: 17 Rebstockbad – Messe – Hauptbahnhof – Baseler Platz – Friedensbrücke – Stresemannallee / Gartenstraße – Stresemannallee – Mörfelder Landstraße – Louisa – Stadtwald – Stadtgrenze Neu-Isenburg
  • Frequency: Every 10 minutes (during the day), 20 minutes (evening)
  • Construction period: January to December 2014 (approx. 250 days)
  • Cost: €20 million
  • Tracks laid: approx. 4,600 m
  • Green track laid: approx. 600 m
  • Track switches installed: 15
  • Rail crossings installed: 7
  • Overhead lines installed: approx. 2,540 m
  • Masts installed     (for lines, signals, etc.): 165
  • Manholes and distribution boxes dug (for various lines and cables): 220
  • Cables stretched (for power, signals, etc.): approx. 12,050 m
  • Pipes laid (for gas, water, power, communication, etc.): approx. 23,420 m
  • Trenches dug (roads, tracks, pavements, etc.): approx. 14,850 m³
  • Kerb laid: approx. 8,670 m
  • Ballast installed: approx. 30,080 m²
  • Asphalt laid: approx. 23,960 m²
  • Paving and flagging laid: approx. 10,030 m²
  • Trees felled: 26
  • Trees planted: 45
  • Previous number of parking spaces: 55
  • New parking spaces: 70
  • Project participants (excl. construction workers): approx. 210 people
  • Construction workers: approx. 100
  • Constituency surgery visitors: approx. 40

Stresemannallee opening ceremony image gallery

[Translate to english:] Zur Bildergalerie Eröffnungsfeier Stresemannallee

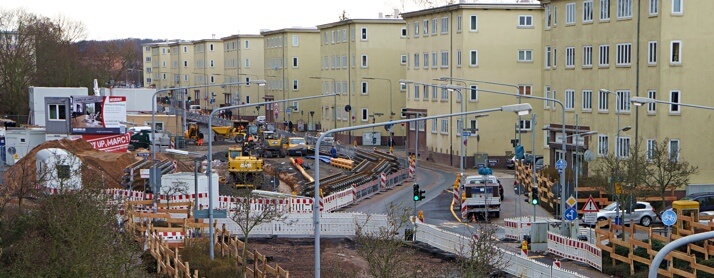

Stresemannallee building works image gallery
